Contractor Oversight

How Do You Manage Change Orders In A Project?

You manage change orders by documenting every adjustment in writing, pricing it line by line, and getting client sign-off before work proceeds.

Simple in theory.

Harder in practice, because change orders touch budget, timeline, and design intent all at once.

We’ll break down what a change order is, why they happen, the step-by-step process, and the best practices that keep your project from spiraling.

Key Notes

  • Change orders are triggered by three things: hidden site conditions, scope changes, and allowance gaps.

  • A clean change order process runs through six steps, from identifying the trigger to updating drawings.

  • Line-item pricing, written approval, and a running log keep budgets from drifting unnoticed.

What Is A Construction Change Order?

A construction change order is a formal, written amendment to the original construction contract

It's used when scope, materials, or site conditions change after the contract has been signed, and it defines three things:

  • what's being adjusted

  • how much it will cost

  • how it affects the timeline

For A Change Order To Protect You, It Needs To Be:

  • Written, never verbal

  • Specific about what's being added, removed, or modified – no vague language like "renovate kitchen further"

  • Priced with line-item clarity, so you can see exactly where the money is going

  • Signed by both client and contractor before any work proceeds

One Distinction Worth Understanding:

  • A proposed change order is the priced request the contractor submits for your review.

  • An executed change order is the signed, approved amendment that becomes part of the contract.

The proposed version is a starting point for the conversation, not the final word.

You're allowed to question it, push back on pricing, or ask for clarification before signing. A good contractor expects you to.

Why Do Change Orders Happen?

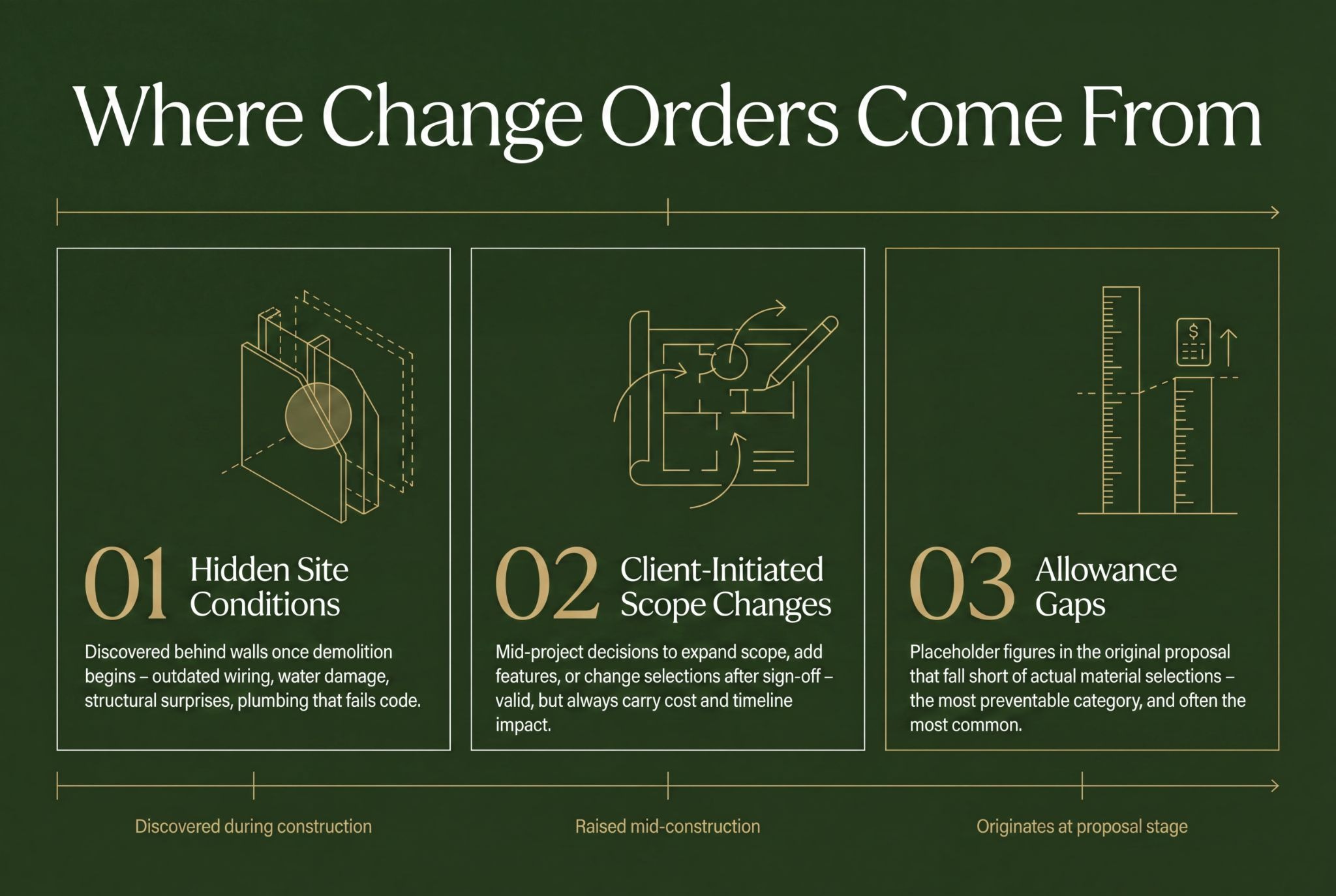

Change orders generally fall into three categories, and understanding which one you're dealing with tells you a lot about what's reasonable to expect.


The Change Order Process, Step By Step

A well-run change order process has six steps.

Each one matters, and skipping any of them creates ambiguity that almost always costs the homeowner money.

Step 1: Identify The Trigger

Someone flags the change formally. The GC raises a hidden condition, the client requests a scope adjustment, or the design team notes that a selection has exceeded its allowance.

Whoever spots it puts it on the table (in writing, not in a hallway conversation).

Step 2: Assess Design & Construction Impact

Before anyone prices the change, the design team reviews it.

A change that looks small on the surface (relocating an outlet, swapping a tile pattern, moving a vanity by a few inches) can ripple into adjacent decisions: clearances, materials already ordered, sequencing of trades.

This review catches the downstream effects before they become their own change orders.

Step 3: Issue The Proposed Change Order

The contractor drafts a written proposed change order with line-item pricing, a clear scope description, and the timeline impact.

This is where vague language gets rewritten into specifics.

"Adjust kitchen layout" becomes "Relocate plumbing rough-in 14 inches east, supply and install one additional cabinet panel to match approved finish, two additional hours of labor for tile cut adjustments."

Specificity here protects everyone.

Step 4: Review For Fairness & Necessity

This is where the value of an independent review shows up.

  • Pricing should be benchmarked against current market rates and the contractor's own pricing on previous comparable work.

  • Scope should be checked for completeness – is anything missing that will become a second change order next week?

  • Timeline impact should be pressure-tested.

If something looks inflated, redundant, or unnecessary, it gets flagged before approval.

Step 5: Client Approval In Writing

No verbal go-aheads. The client signs, the GC signs, and the executed change order becomes part of the contract record.

Anything else creates dispute risk down the road.

Step 6: Update Design Documentation

Drawings, specs, and material orders get revised so the build team is working from current information.

Skip this step, and the GC ends up executing from the original plan with a few mental adjustments – which is how installations end up not matching the approved change.

Construction Change Order Best Practices

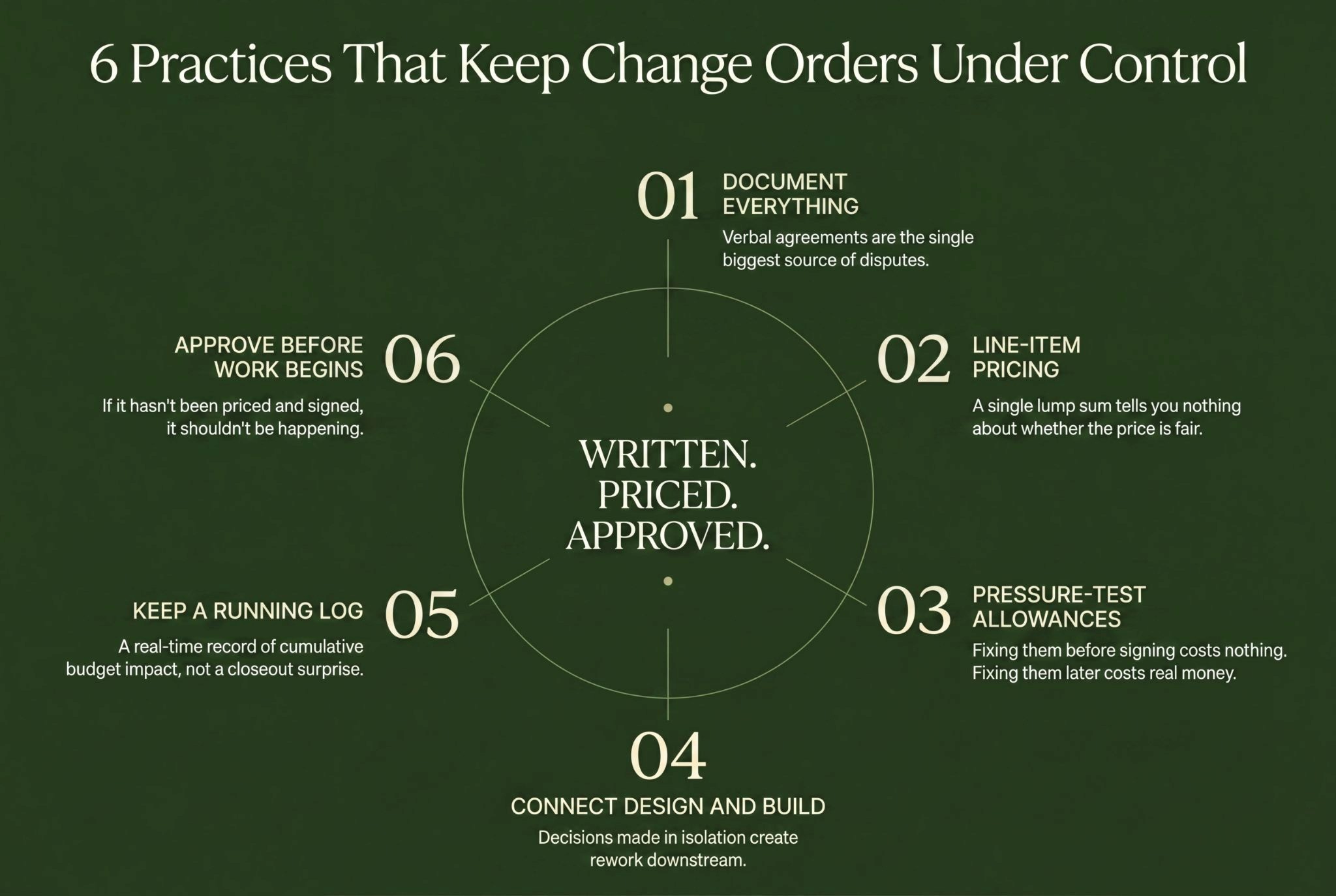

The difference between projects that manage change orders well and projects that don't usually comes down to six practices:


1. Get Every Change In Writing Before Work Begins

Verbal agreements during a site visit are the single biggest source of renovation disputes. Make written documentation non-negotiable from day one.

If a contractor pushes back on this, that tells you something important about how the rest of the project will go.

2. Insist On Line-Item Pricing

"Additional work – $4,200" tells you almost nothing.

A proposed change order should break down into:

  • Demolition or prep work

  • Materials (with quantities)

  • Labor hours

  • Any sub-trade involvement

That level of detail tells you whether the price is fair and gives you something specific to question if it isn't.

3. Pressure-Test Allowances Upfront

Most change order disputes trace back to allowances set too low at proposal stage.

Before signing the original contract, walk through every allowance with the contractor and ask what that number realistically buys in today's South Florida market.

Fix it then. It costs nothing to adjust an allowance before signing, but it costs real money to fix one through a change order three months in.

4. Keep Design & Construction Conversations Connected

A change that touches plumbing, electrical, or structure has design implications. A change to design has construction implications. Decisions made in isolation create rework.

The design lead should review every change order, not just the GC.

5. Build A Running Change Order Log

Keep a simple record of every change, its cost, and the cumulative budget impact.

This is one of those administrative details that feels minor until you're three months in and trying to remember whether you're over or under contingency.

A log gives you the real number, in real time.

6. Approve Before Work Proceeds

The most expensive mistake homeowners make is letting work proceed under "we'll sort it out at the end." That's how a proposed change order becomes a dispute.

If the work hasn't been priced and signed, it shouldn't be happening.

A Quick Word On Cost-Plus Contracts…

Under cost-plus pricing, every change feels less consequential because the structure already passes costs through.

In practice, this is exactly where projects spiral. Fixed-price contracts with disciplined change orders give the homeowner far more control over the final number.

The Owner's Representative Role During Change Orders

Most homeowners go through change orders with no one in their corner:

  • The GC writes the proposed change order

  • The client signs it or doesn't

  • There's no independent review of whether the change is necessary, whether the price is fair, or whether it creates downstream design problems.

An owner's representative changes that dynamic.

What An Owner's Representative Does

The role covers four distinct functions during the change order process:

  • Reviews proposed change orders for scope completeness and pricing fairness before they reach you for signature.

  • Coordinates design updates so drawings, specs, and material orders stay aligned with the new scope.

  • Briefs you in plain language on what's changing, what it costs, what the alternatives are, and whether it's worth doing.

  • Documents every decision so the GC, design team, and client are all working from current information.

Need Someone In Your Corner Before Renovation Starts?

A free call to align on what you want, what it'll cost & how to get there.

How Do You Manage Change Orders In A Project? FAQs

Who pays for a change order?

The homeowner pays for a change order in most cases, since change orders represent work outside the original contract scope. The exception is when a change is caused by contractor error or work that wasn't performed to the agreed specification – those corrections are the contractor's responsibility, not a billable change order.

How long does a change order take to approve?

A change order should take 24 to 72 hours to approve in a well-run project – long enough to review pricing, assess design impact, and ask questions, short enough to avoid stalling the build. Anything pushed for same-day approval without documentation is a red flag.

What's the difference between a change order and a variation?

A change order and a variation describe the same thing – a formal amendment to the original contract covering a change in scope, materials, or conditions. "Change order" is the standard term in the US construction industry, while "variation" is more common in UK, Australian, and international contracts.

Can a contractor do work without a signed change order?

A contractor should not do work without a signed change order, and any reputable GC will refuse to. Work performed without written authorization creates ambiguity over who owes what – and in most US states, contractors have limited legal recourse to collect payment for unauthorized work.

Conclusion

So… how do you manage change orders in a project?

A well-managed change order process protects three things at once: your budget, your timeline, and the design you signed off on.

Without discipline, all three drift quietly until closeout. With it, the mid-project adjustments that every renovation produces stay contained, priced fairly, and approved on your terms.

The homeowners who manage change orders in a project well do so because the structure exists upstream – clear scope, honest allowances, written documentation, and someone independent reviewing every proposed change before it gets signed.
